- Daily Field Report Report ID: 57365
- This project is inactive from admin.Download Report
Daily Field Report
Date :03/02/2023
Project No :2022C235
Client Company :Jackson Demolition Service, Inc.
Arrival Time :03/02/2023 06:00
Onsite Hours :10:30
Name of the Project :Plant Gorgas Demolition and Grading
Project Location :460 Gorgas Rd, Parrish, AL 35580
Weather :RAINY
Departure Time :03/02/2023 16:30
ASEC Technician Name :Vidal Dias
Observations/Finding
AS ENGINEERING AND CONSULTING, LLC (ASEC) representative Vidal Dias visited the site at the request of Jackson Demolition representative Josh Kelly. The undersigned representative was present to monitor, verify and document the ongoing project activities.
During the visit, the following observations were made:

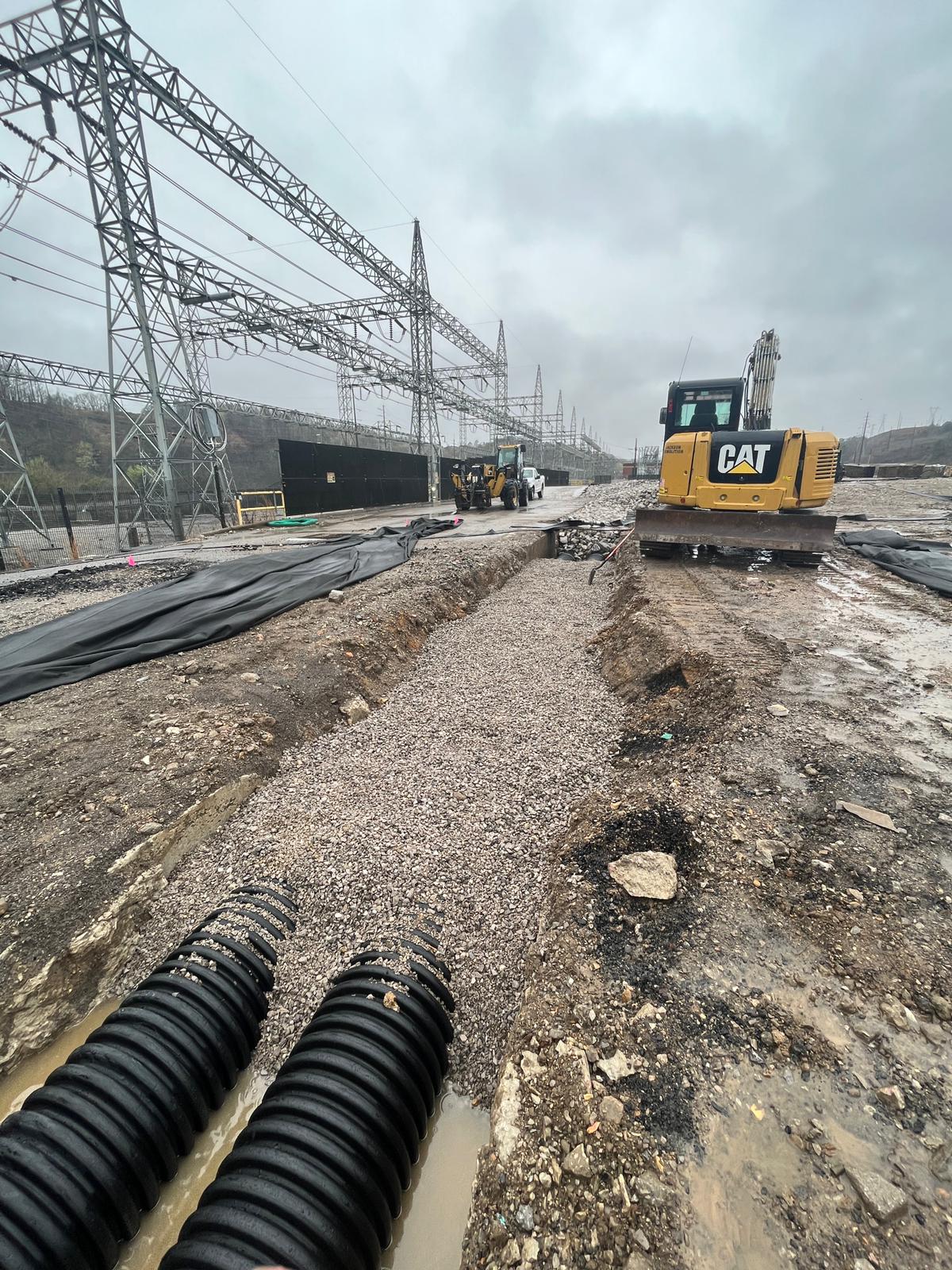

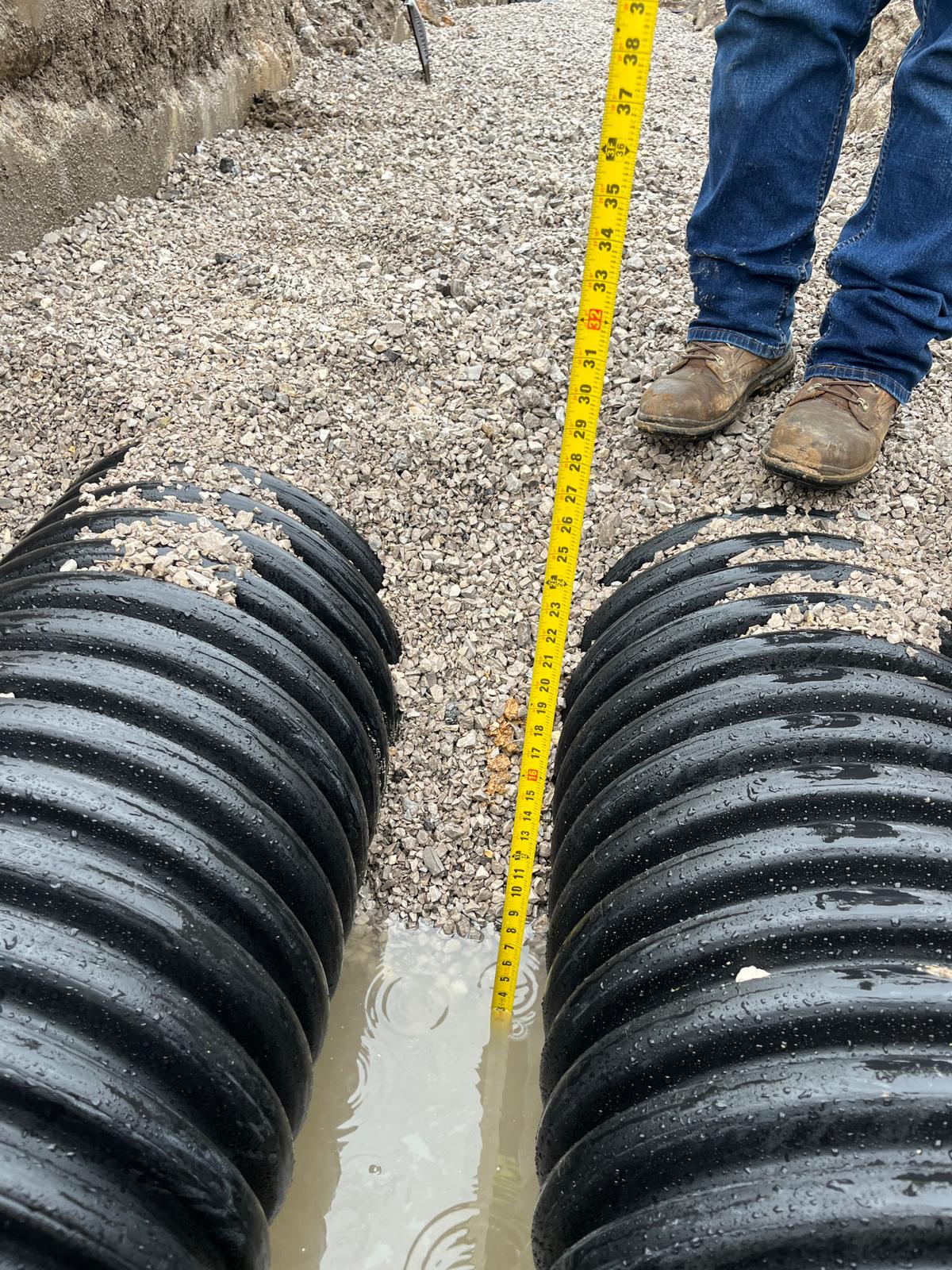

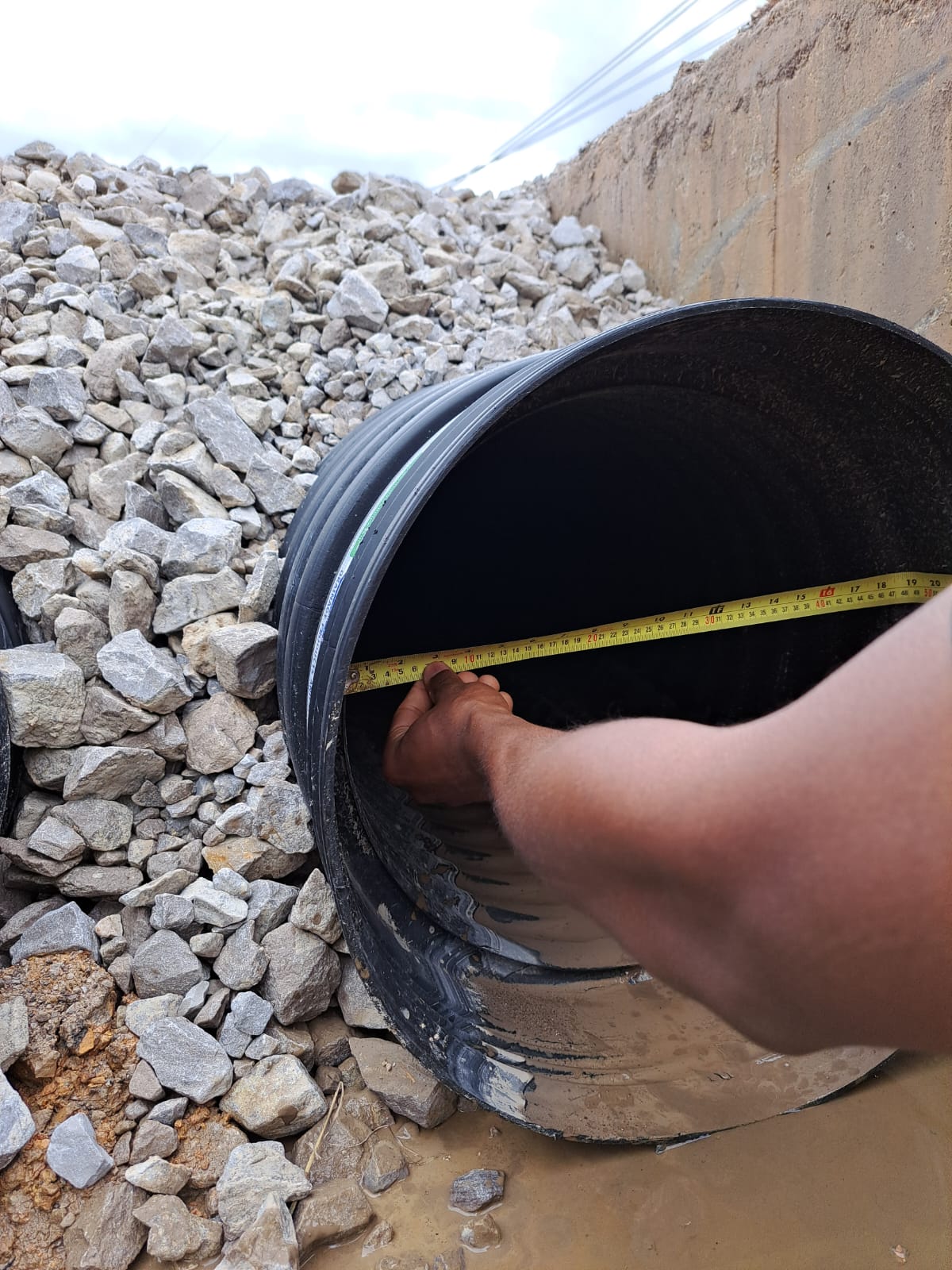

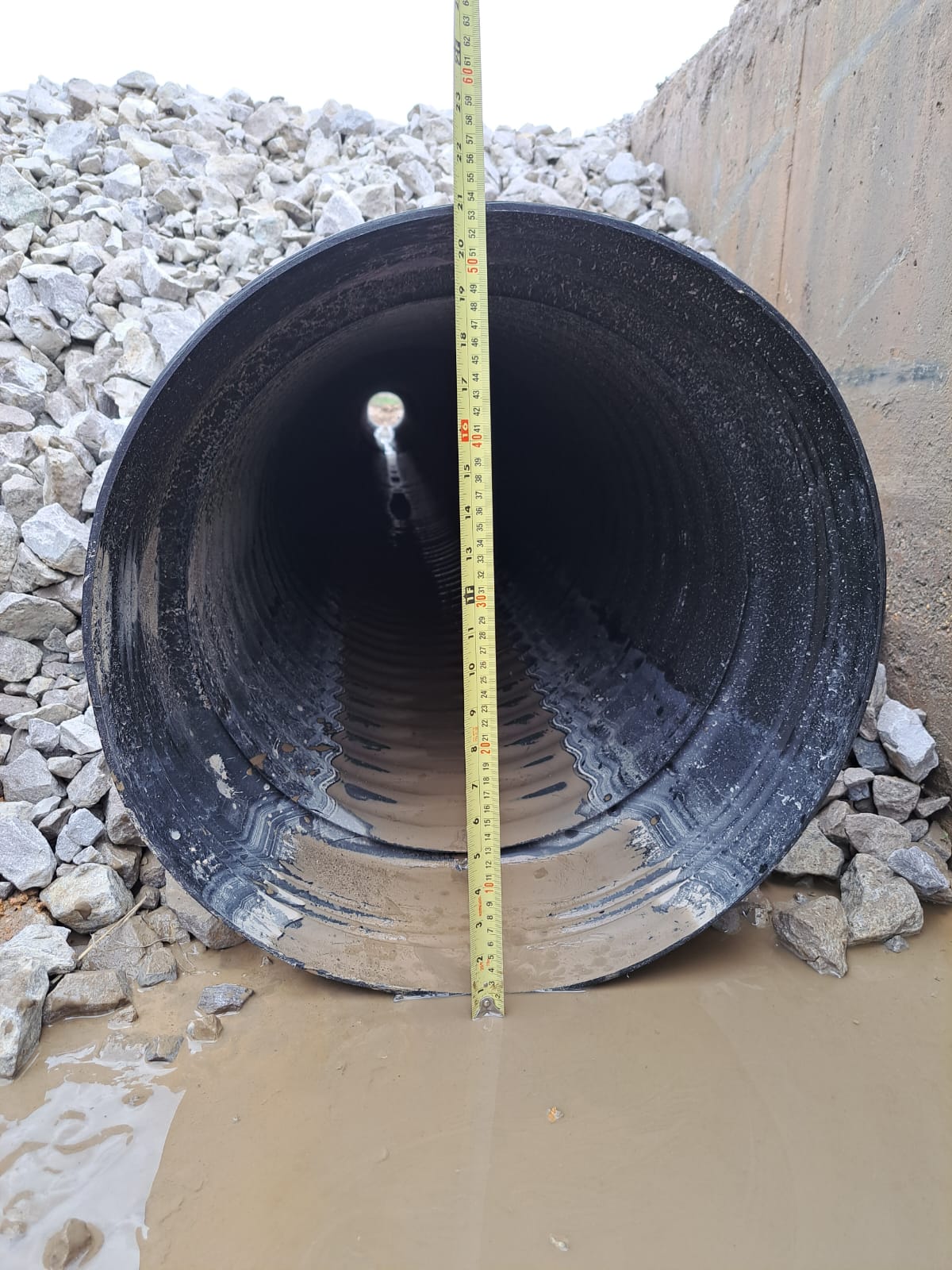

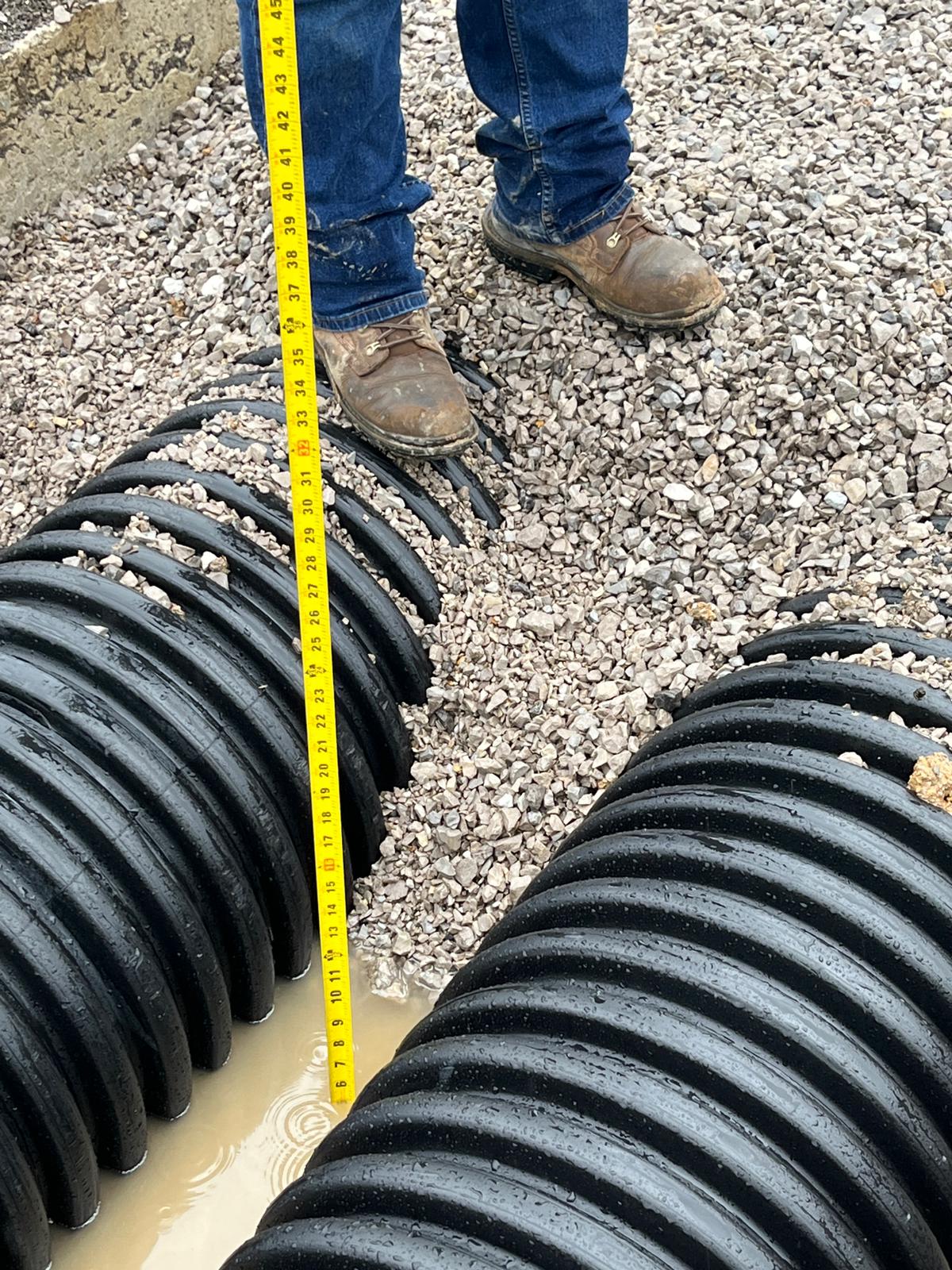

- The contractor placed two 20-inch HDPE pipes with an inner diameter eighteen inches (18″) and outer diameter of O.D (21″) in the south trench located in area F7.

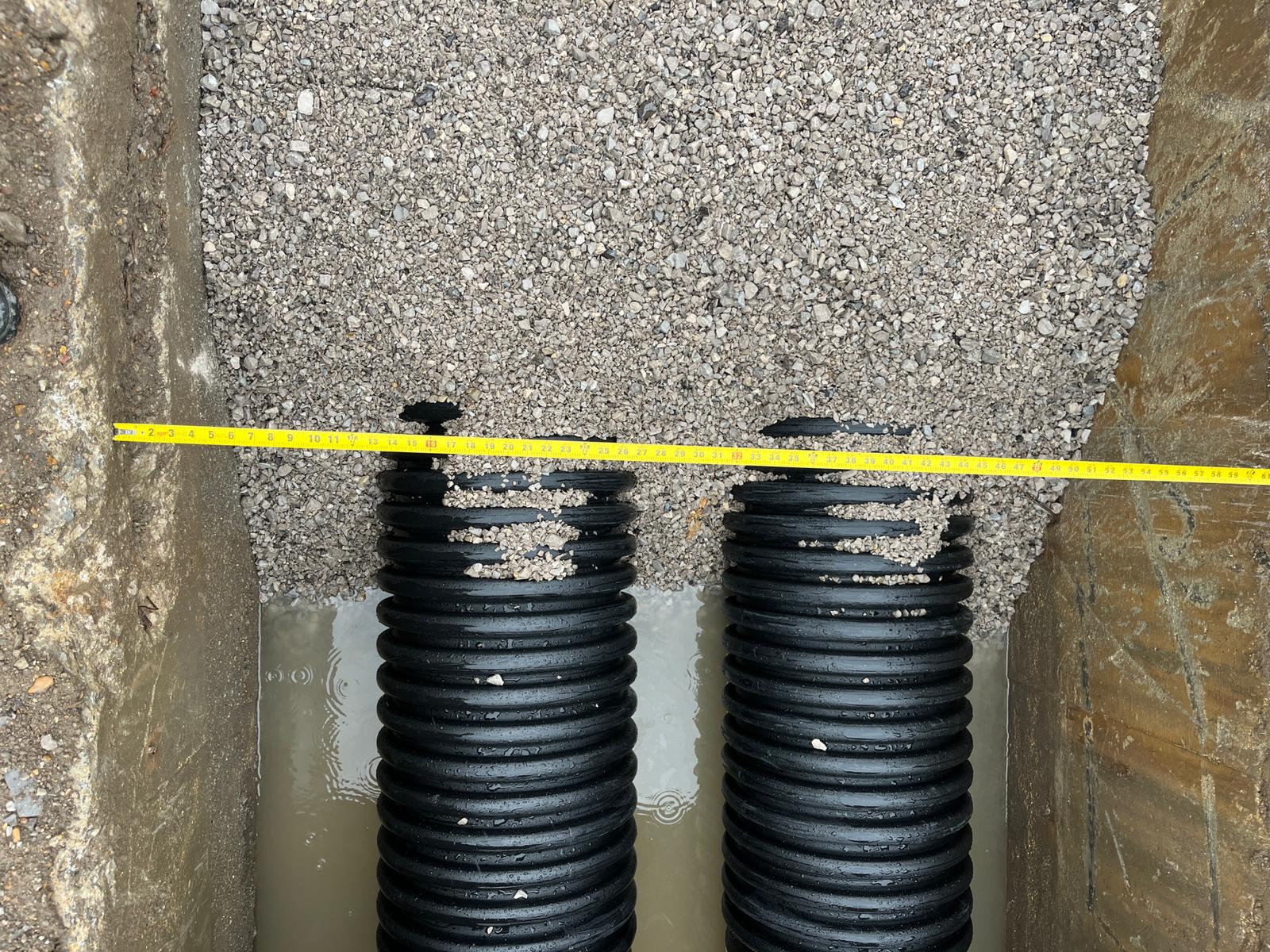

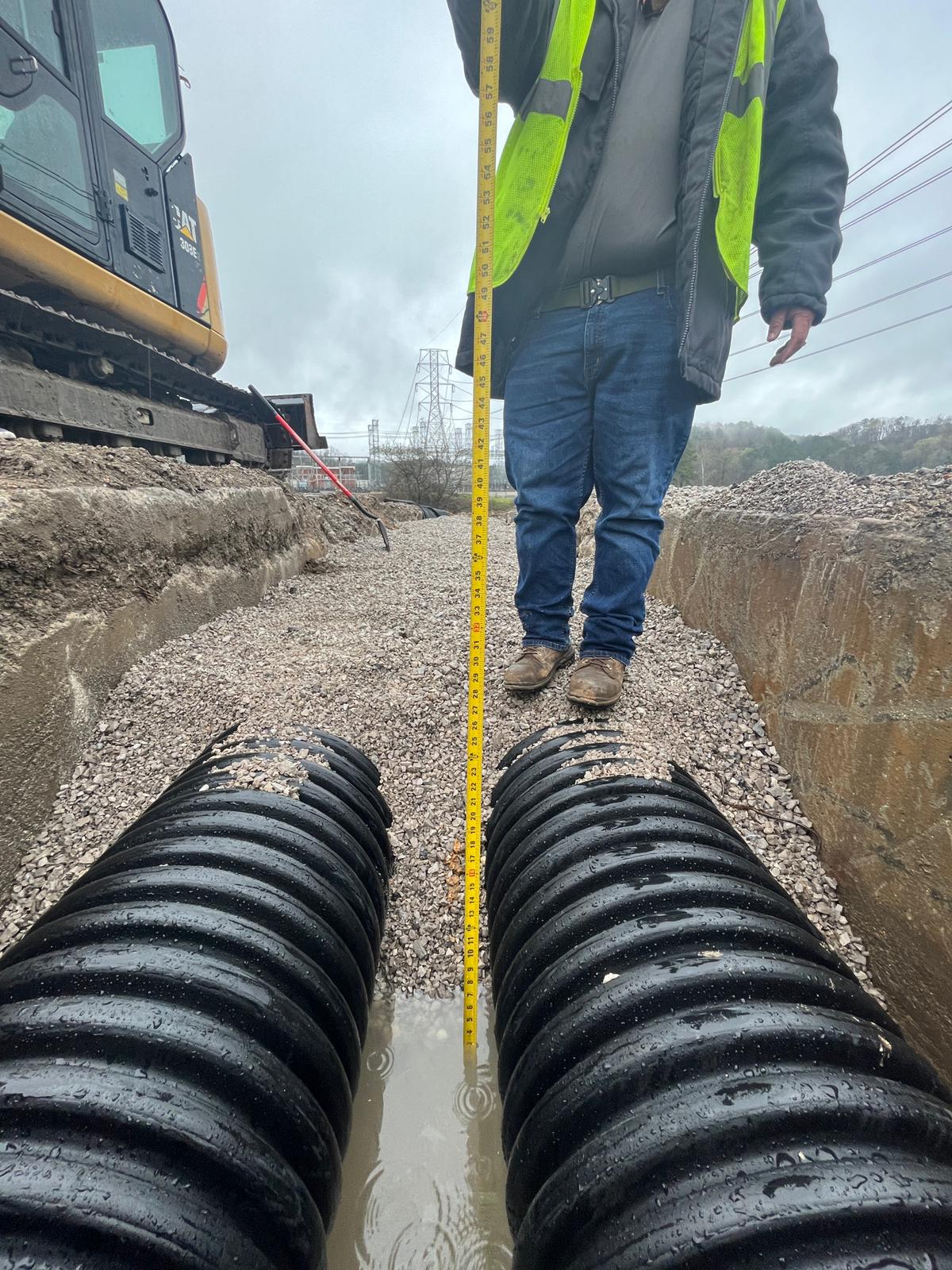

- Fifty-seven (57) stone was placed between pipes and trench walls, up to 4″ inches of cover to the top of the pipe.

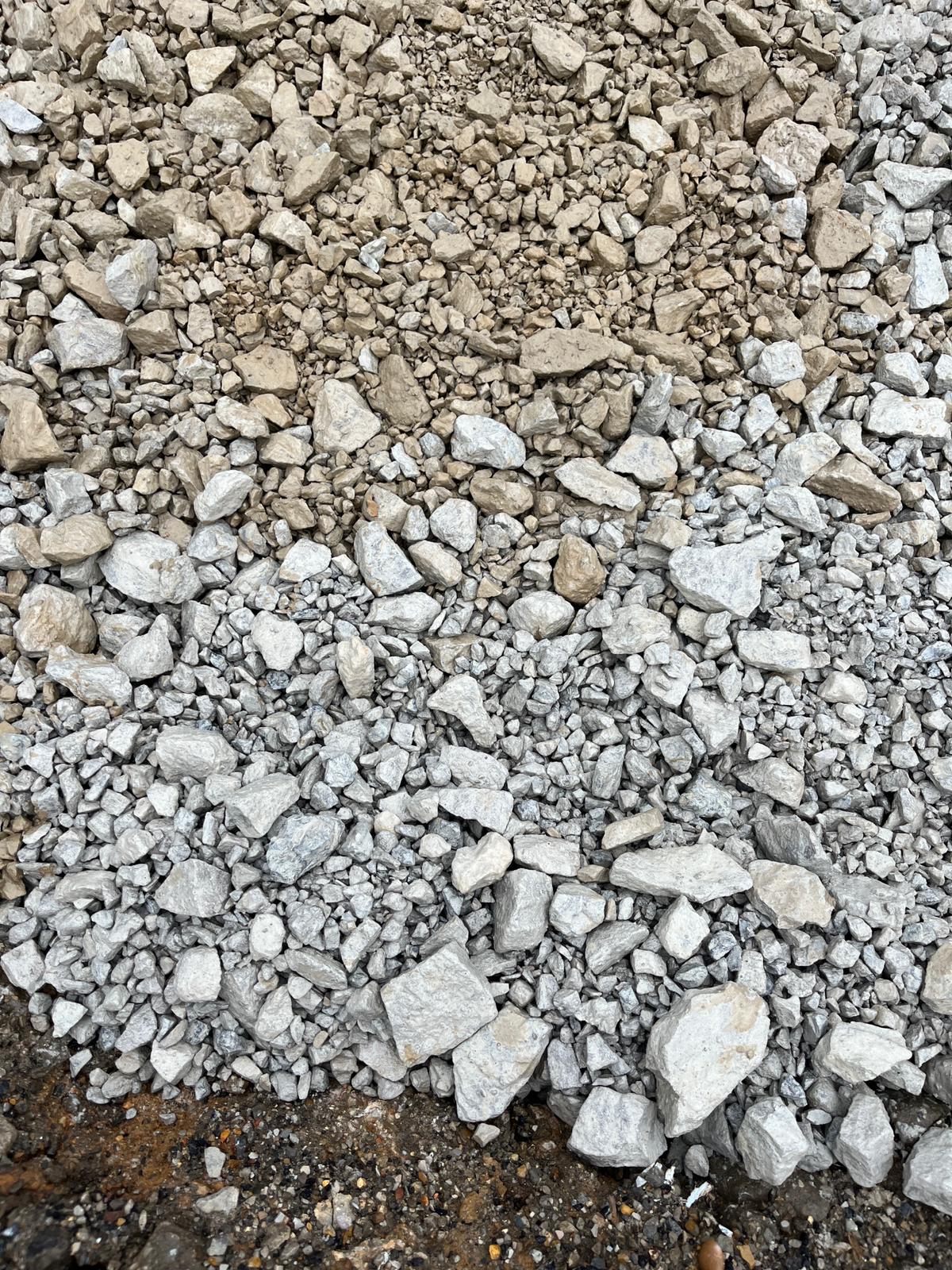

- Fifty-seven( 57) and twenty – four (24) stone was mixed and placed up to eight inches (8″) below the finished grade.
- Materials were placed in accordance with ITP: 013
Photo documentation is included below:
Technician Signature / DateAvinash Bandham, March 2, 2023
Reviewer Name / DateRamchandra Mogulla, March 03, 2023
