Daily Field Report

Date :02/22/2024
Project No :2023C195
Client Company :Toll Bros. Inc.
Arrival Time :02/22/2024 8:30
Onsite Hours :07:30
Name of the Project :Kimbal Bridge Tract
Project Location :Alpharetta
Weather :sunny
Departure Time :02/22/2024 16:00
ASEC Technician Name :Aminullah Azimi

Observations/Finding

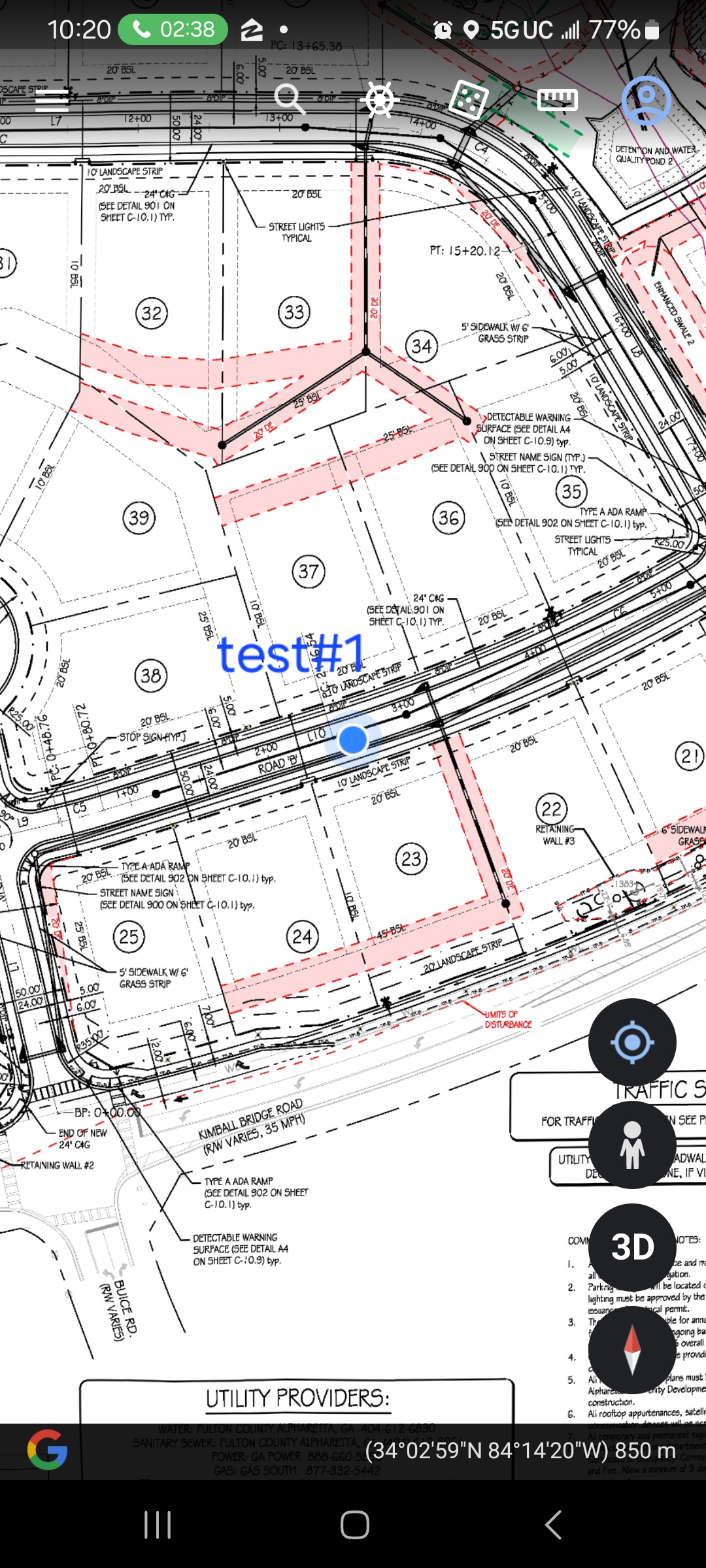

As requested, the site was visited by our AS Engineering and Consulting (ASEC) representative for the purpose of providing quality control inspection and testing services.  Visual observation techniques were employed to verify compliance with project drawing/specifications, applicable codes, and materials submittals. The following observations were observed on site this day.

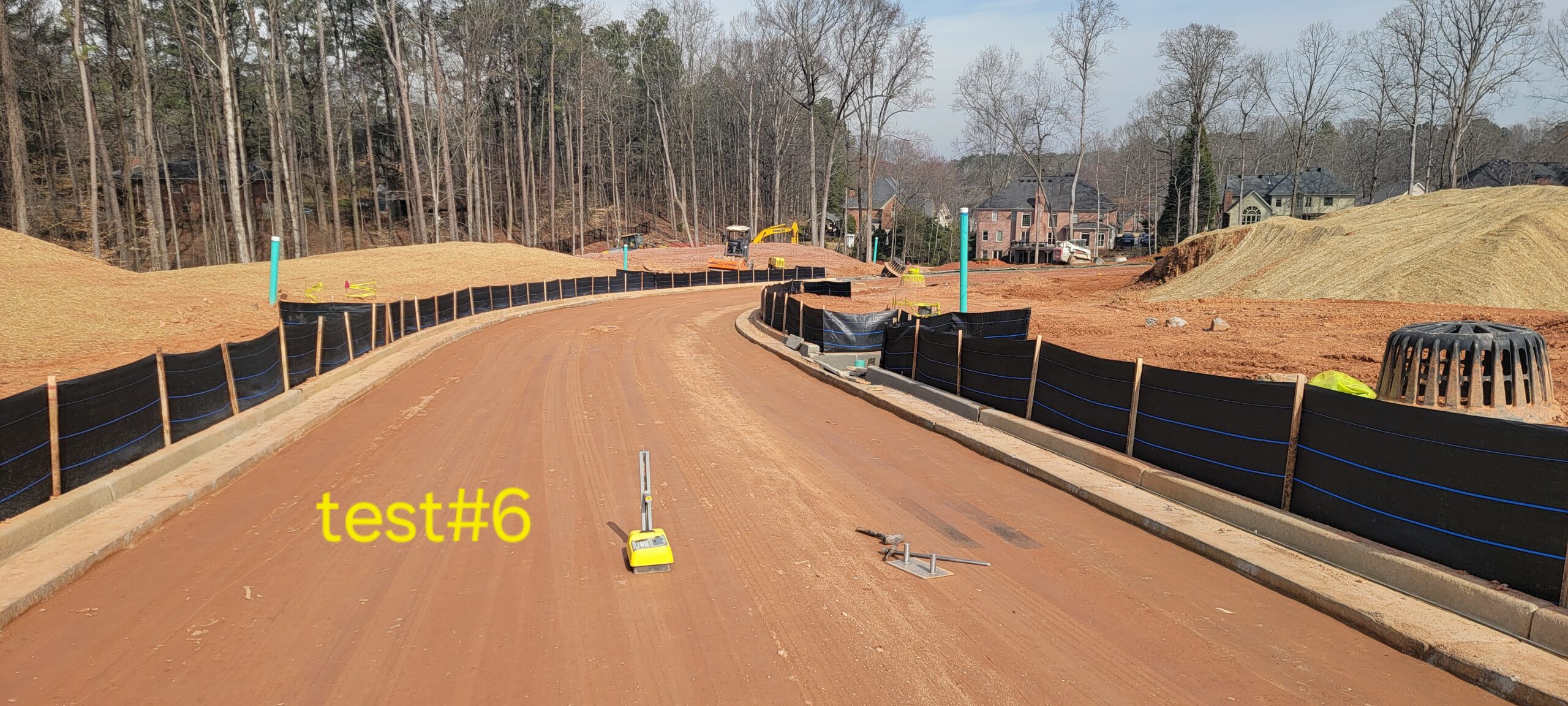

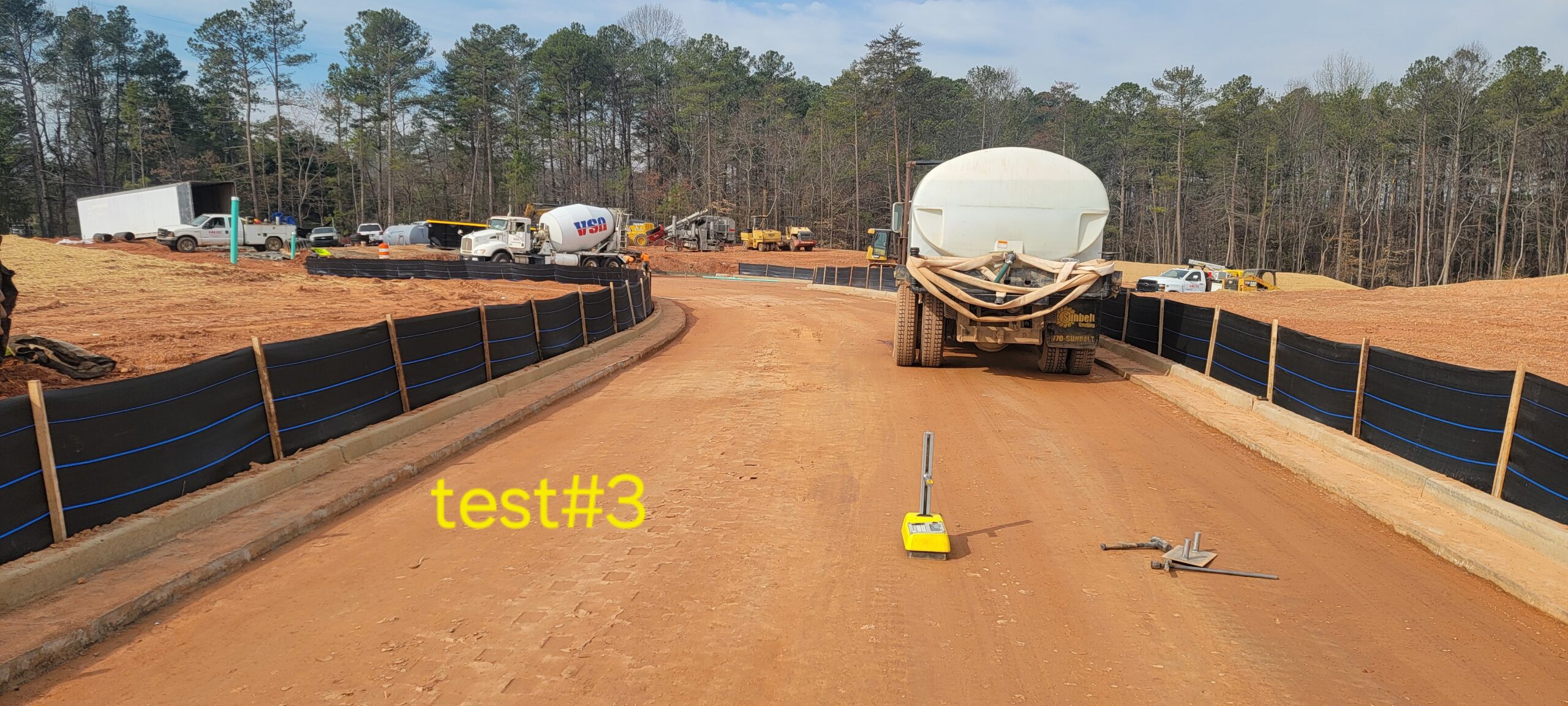

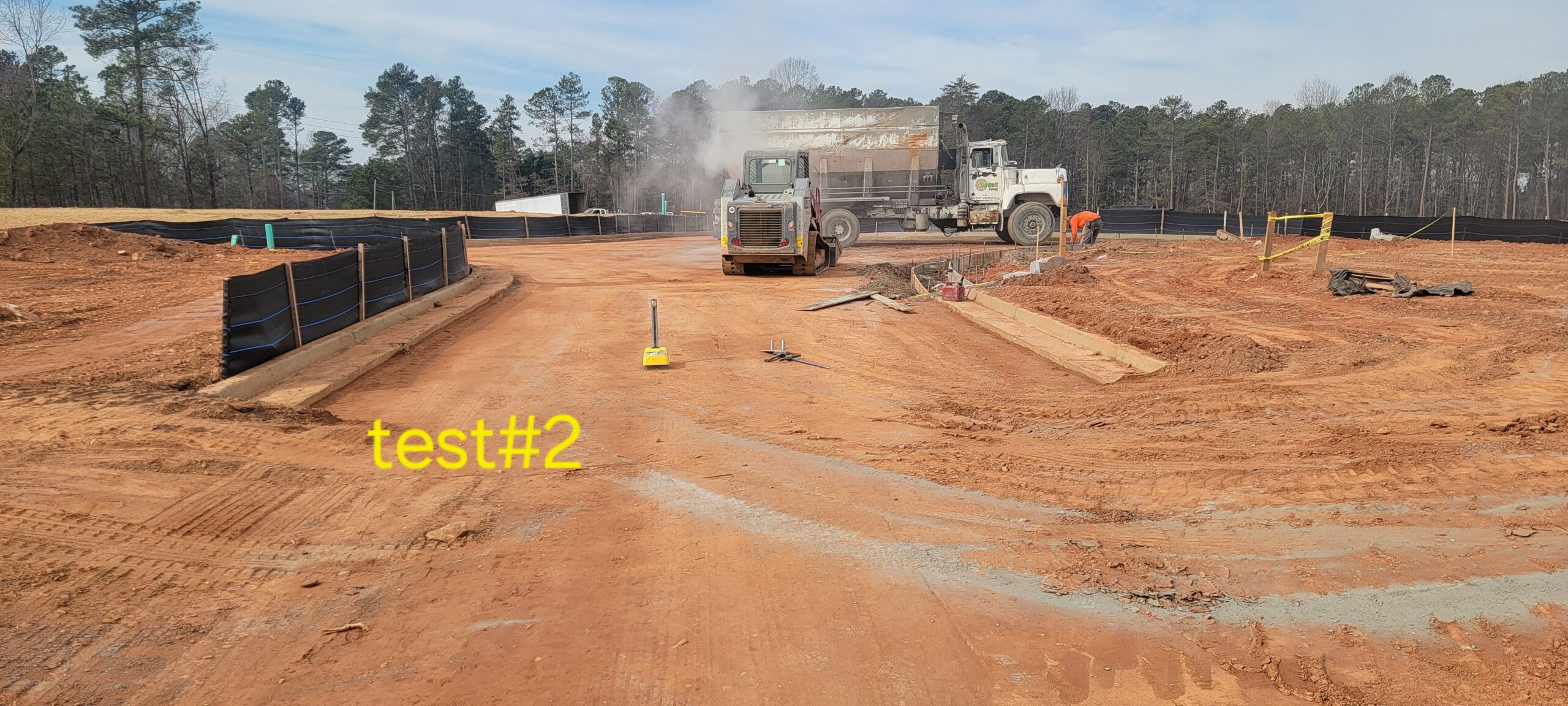

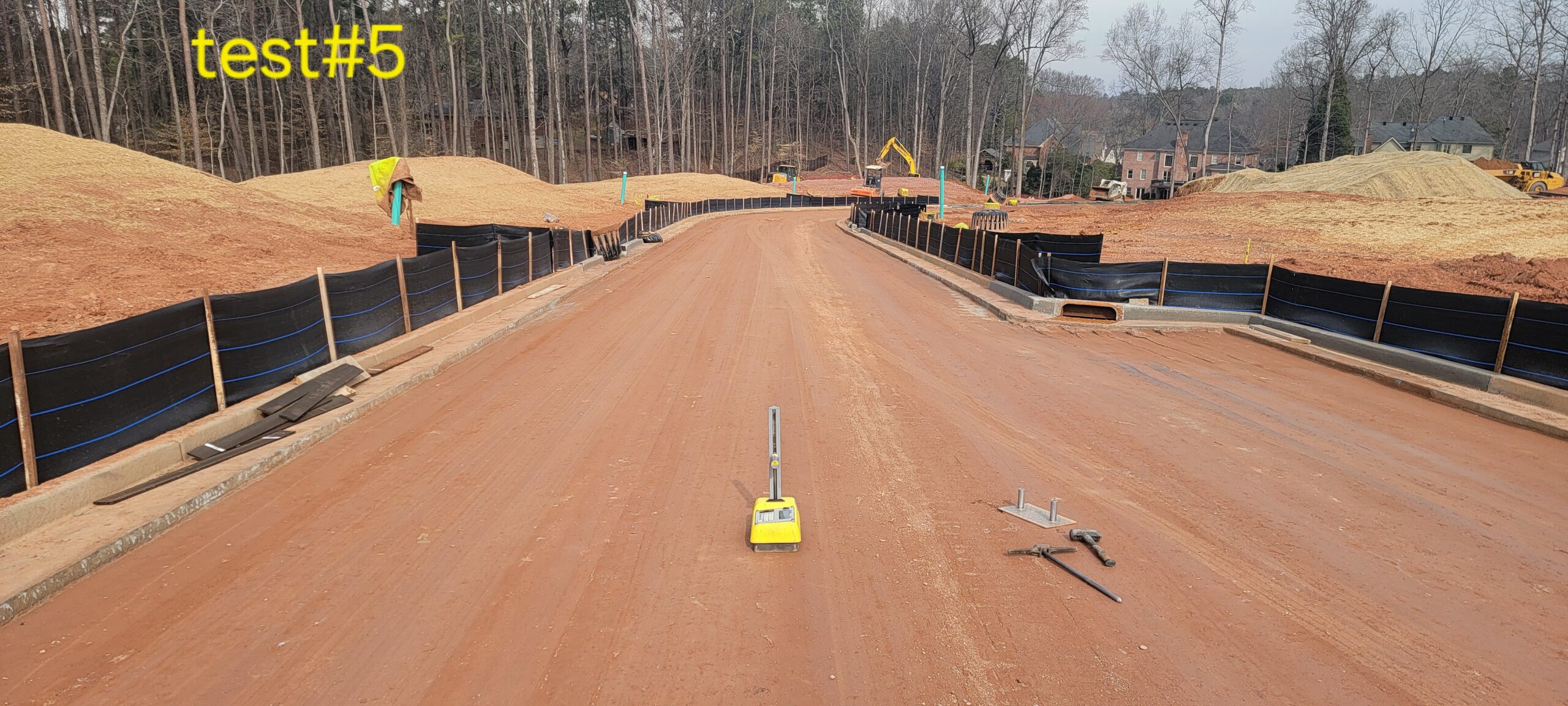

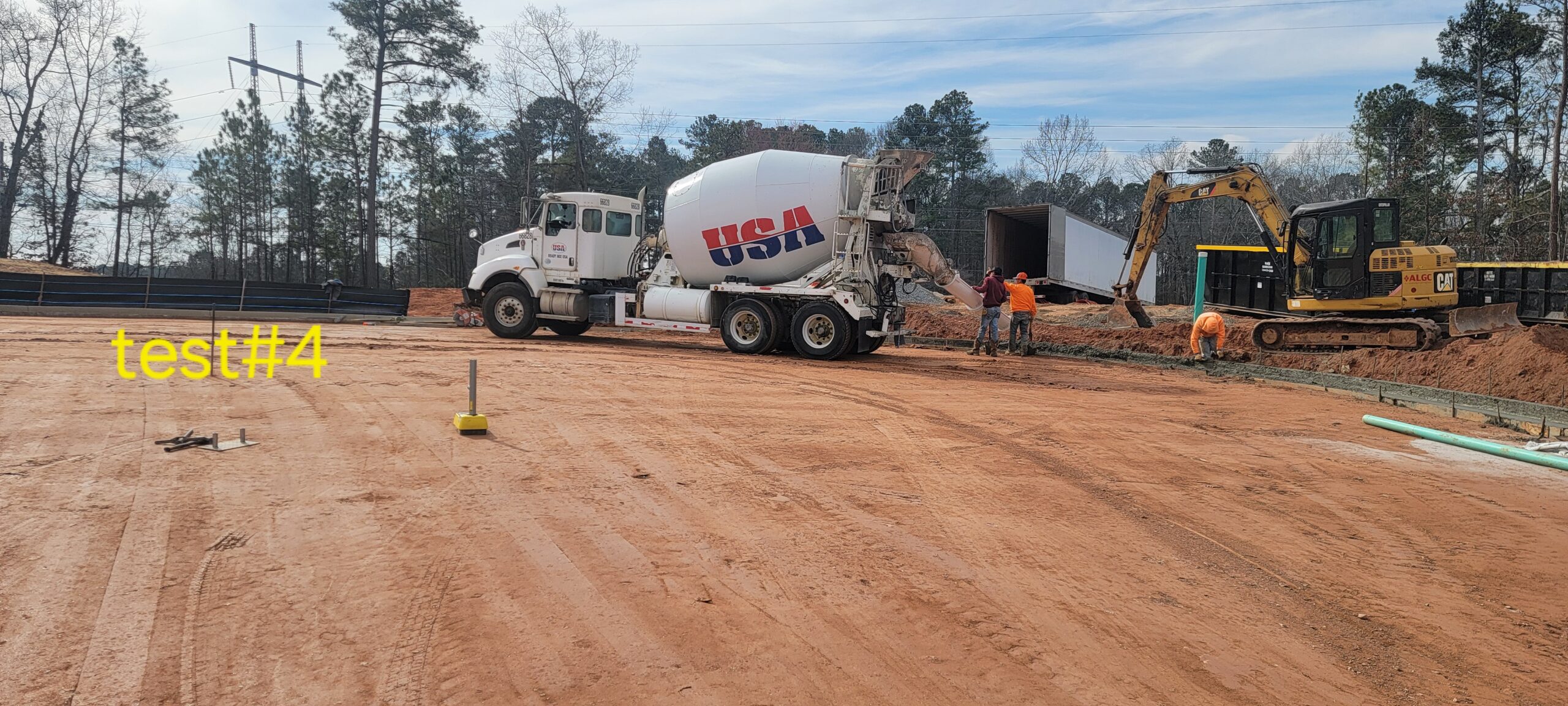

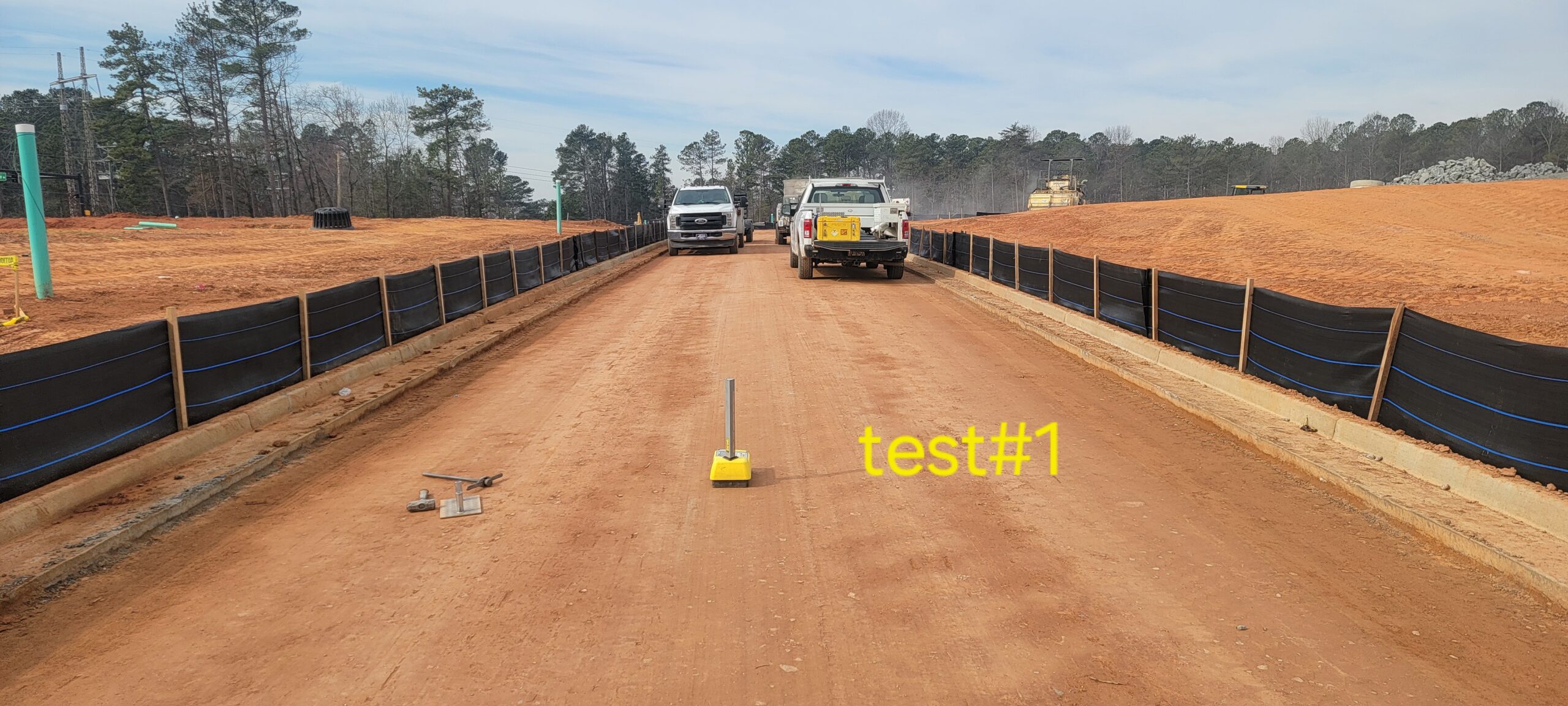

  • Sunbelt Asphalt. Base course placed with approximately 6 inches of Cement Treated Base (CTB) from STA 3+00 to STA 6+00, with density testing following.
  • Sampling of soil cement taken to our laboratory for a moisture-density relationship to be performed.

We appreciate the opportunity to be of service to you on this project. If you have any questions regarding this report, please feel free to contact us. We will be more than happy to discuss it with you.

Technician Signature / DateAminullah Azimi, February 22, 2024
Reviewer Name / DateKenneth Mosman, March 15, 2024
